Large Composite Deck With Aluminum Cable Railing
- 372 sq. ft. Fiberon composite deck
- Westbury black aluminum vertical cable railing
- New concrete landing pad and relocated gutter downspouts
Location: Saltillo Road, Roca, NE
Price: $38,000

Part One: Initial Consultation
Henry and Laurie had lived with their old deck long enough to know it wasn’t going to make it through another Nebraska winter. The boards were weathered, the railings were loose, and water had been finding its way into places it shouldn’t for years.
When they called Deck Bros, they weren’t looking for a patch job. They wanted a bigger, more durable deck built with composite materials that wouldn’t need constant upkeep.
They also wanted matching stairs with a concrete pad and a clean vertical cable railing.
After the pre-construction meeting, we walked away with a clear vision and a plan to get it built right.

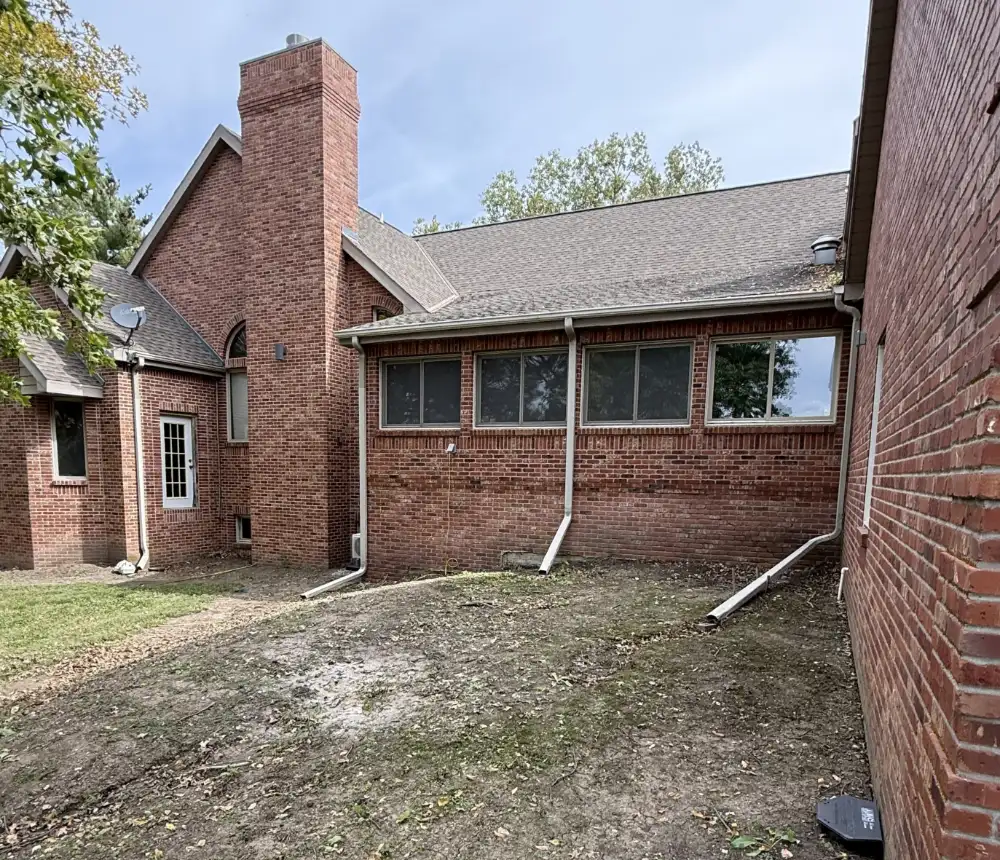

Here's what the on-site consultation revealed...

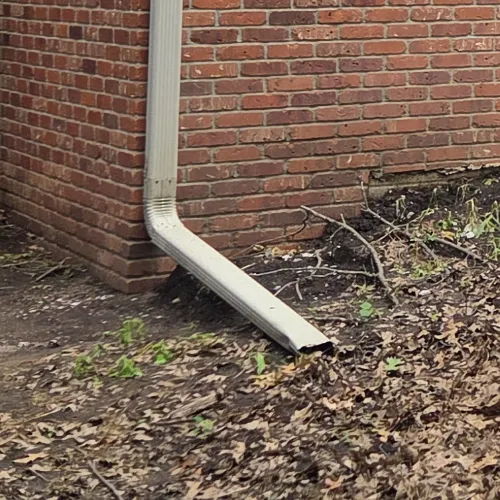

Improper water drainage
Gutter downspouts drained too close to the house, putting the wall framing at risk for rot.

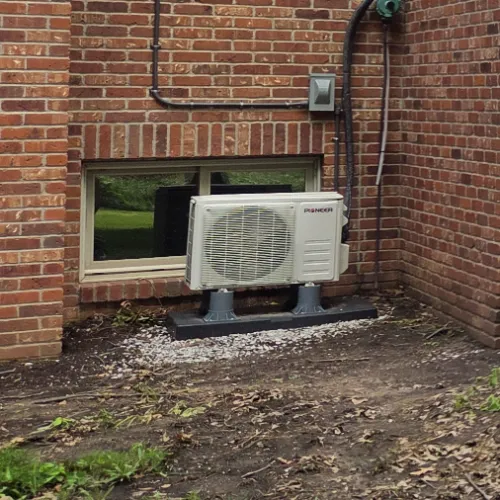

AC mini-split obstruction
A mini-split condenser sat at the corner of the brick foundation where the stairs needed to be.

Tight door clearance
The ledger at the upper entry door had to be set exactly 4 inches below the threshold for a code-compliant connection.

Brick facade spacing
The brick running alongside the stairs ruled out a standard double-sided railing.
Part Two: The Design, Planning, Permitting
We immediately got to work, putting together engineered drawings that accounted for the brick exterior, the tight foundation clearance, and the water damage that had caused problems in the old deck.

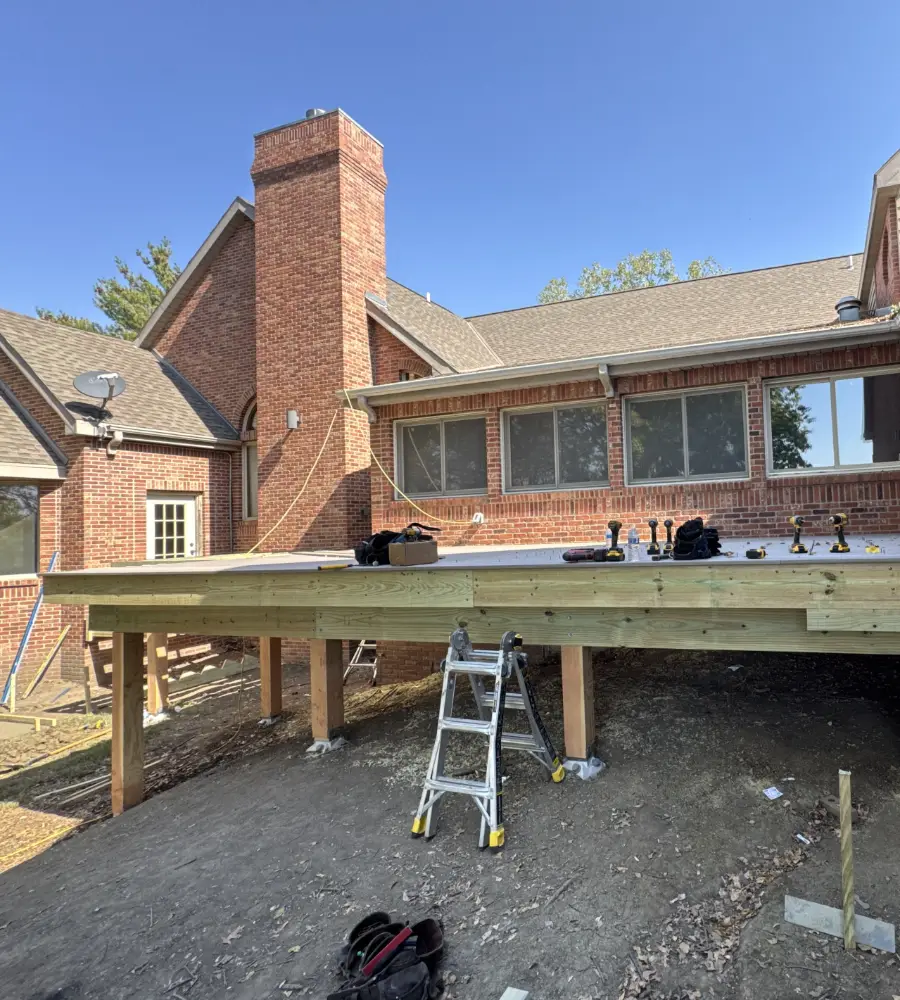

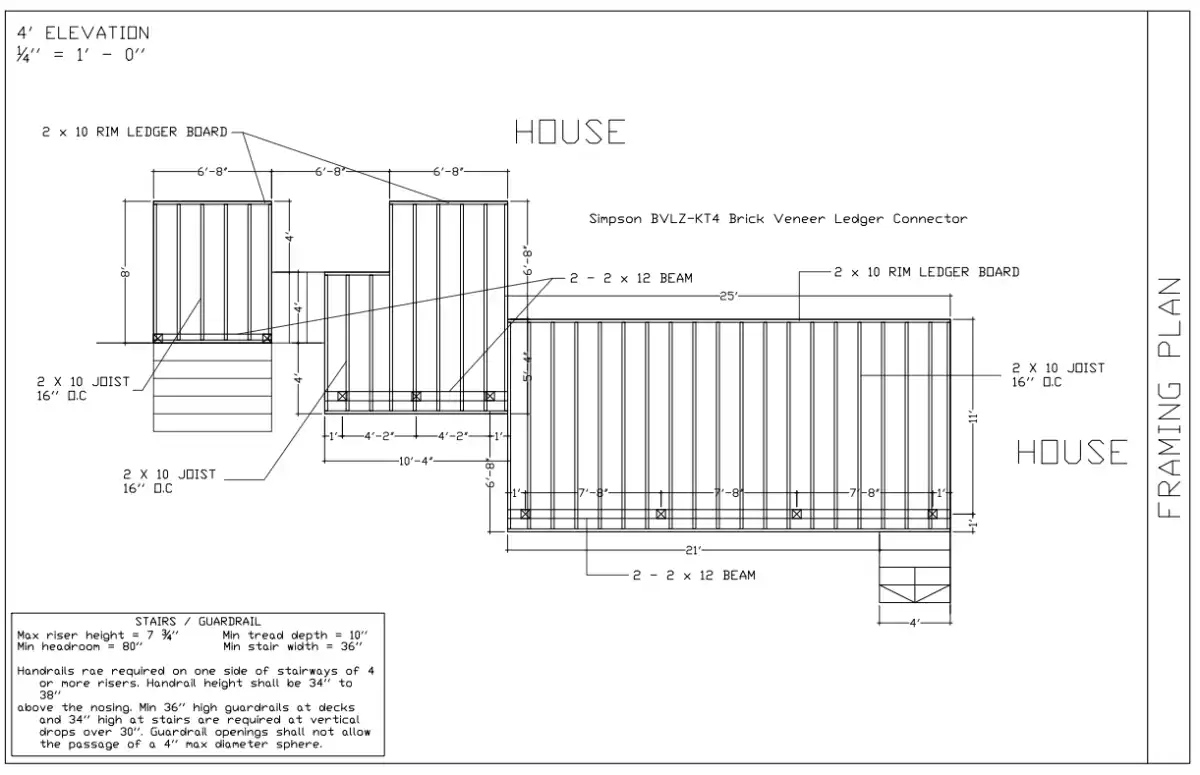

Framing plan

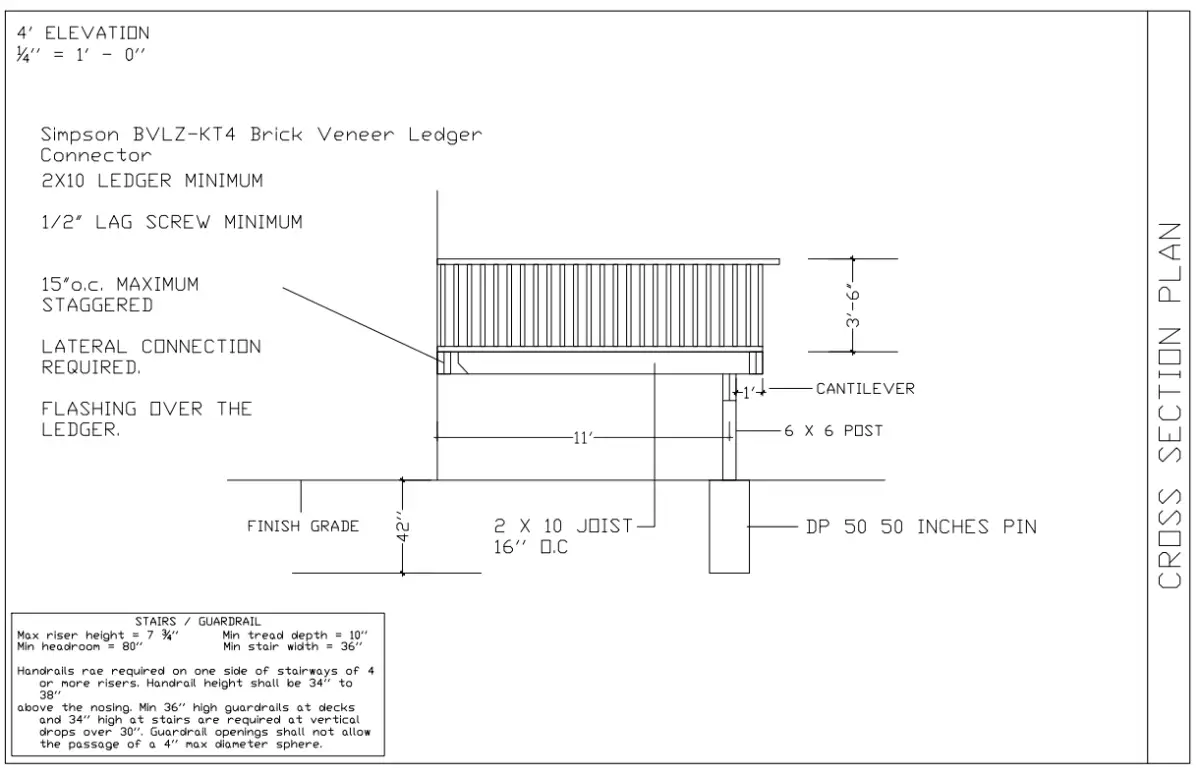

Because the house has a brick exterior, the plan called for a Simpson BVLZ-KT4 brick veneer ledger connector. This lets the deck attach securely to the house framing itself, so the deck’s weight never rests on the brick.

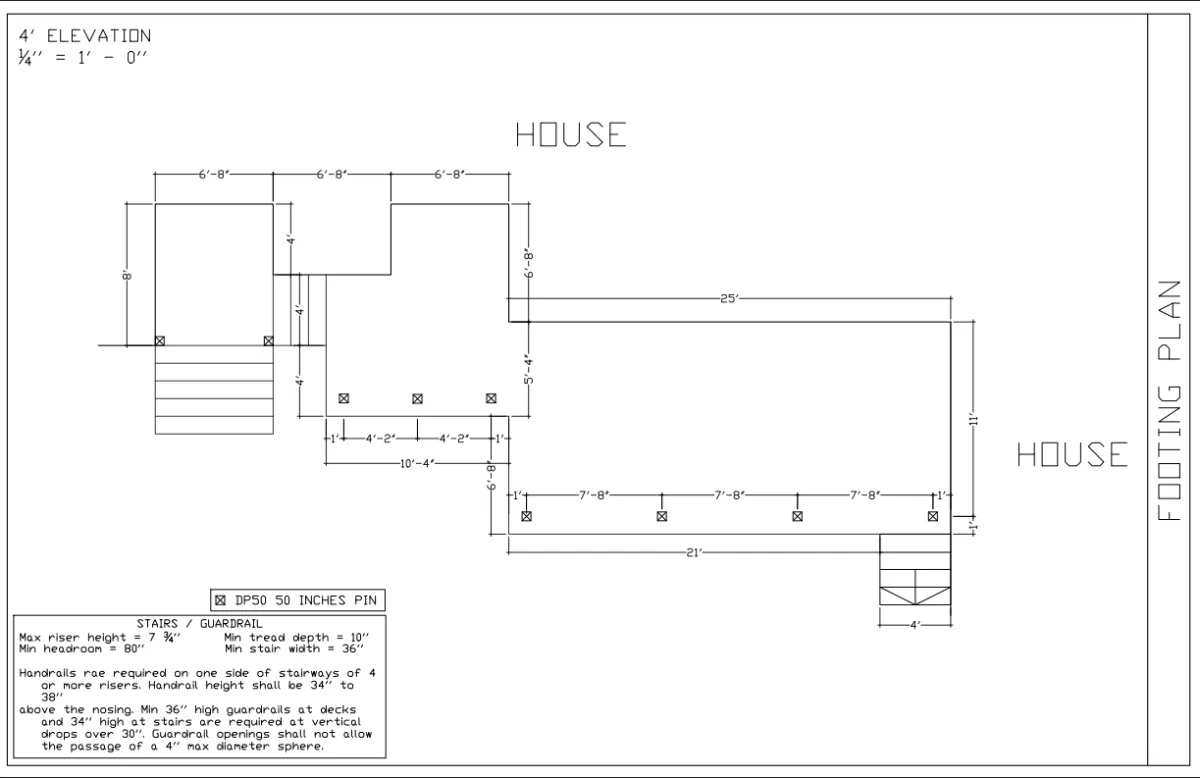

Footing plan
Instead of digging traditional concrete footings, the plan specified Diamond Pier footings driven deep into the ground at each support point around the deck’s perimeter and underneath the main beams.
Part Three: The Time Schedule
This project moved from proposal to final walkthrough in about two months.
August 15
We issued the formal proposal to homeowners Henry and Laurie.
August 17
Henry and Laurie signed and approved the contract.
September 3
We held the pre-construction meeting to review the drawings. The old deck was already removed.
September 30

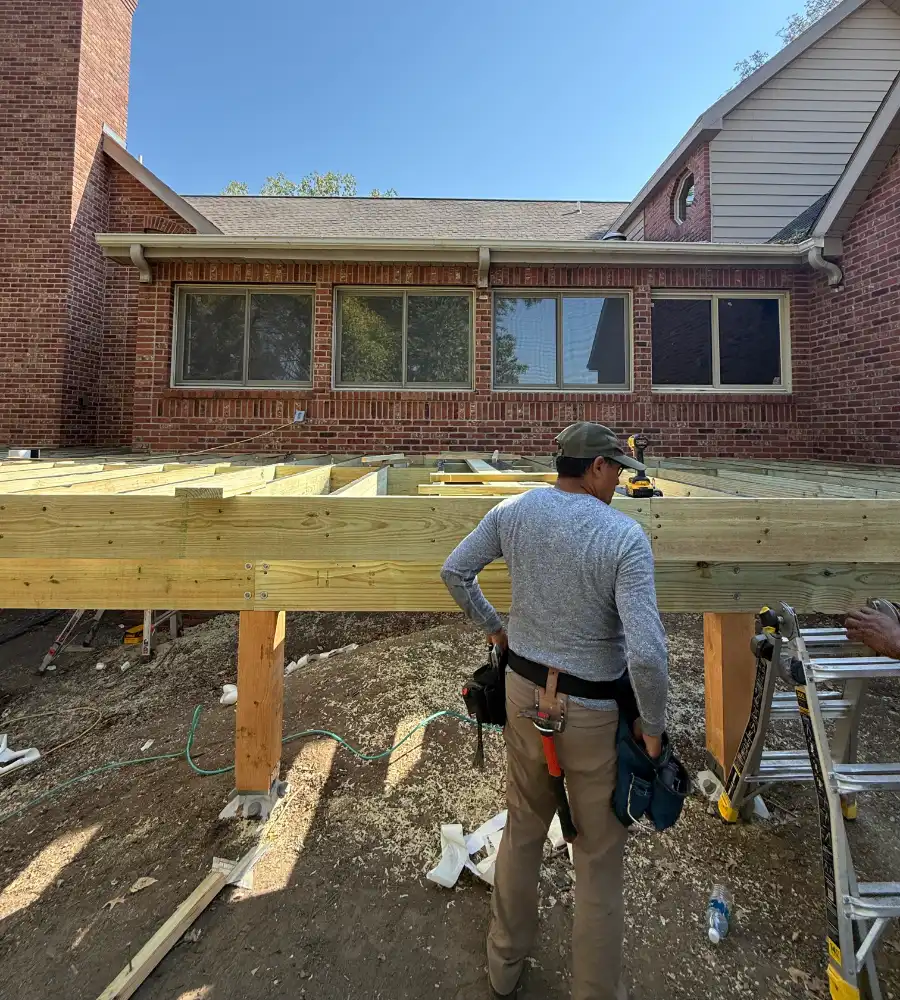

Construction begins. We started on the framing and resolved the Diamond Pier offsets near the foundation.
October 2 - 4
Framing wrapped up, the concrete landing pads were poured, and the composite decking went down. Then, the cable railings went in and we applied the final touches.
October 10
The downspout relocation was complete.
October 13
Final inspections were scheduled and the team walked through the finished deck with Henry and Laurie before collecting the final payment.
What Gordon Said About Deck Bros...
Some of the things the homeowner enjoyed are:
- A finished deck that's exactly as he hoped
- Fast, hassle-free process
- Protective site care and safety
- Accountability
- Consistent communication
- Custom solutions (trap door, modified staircase)

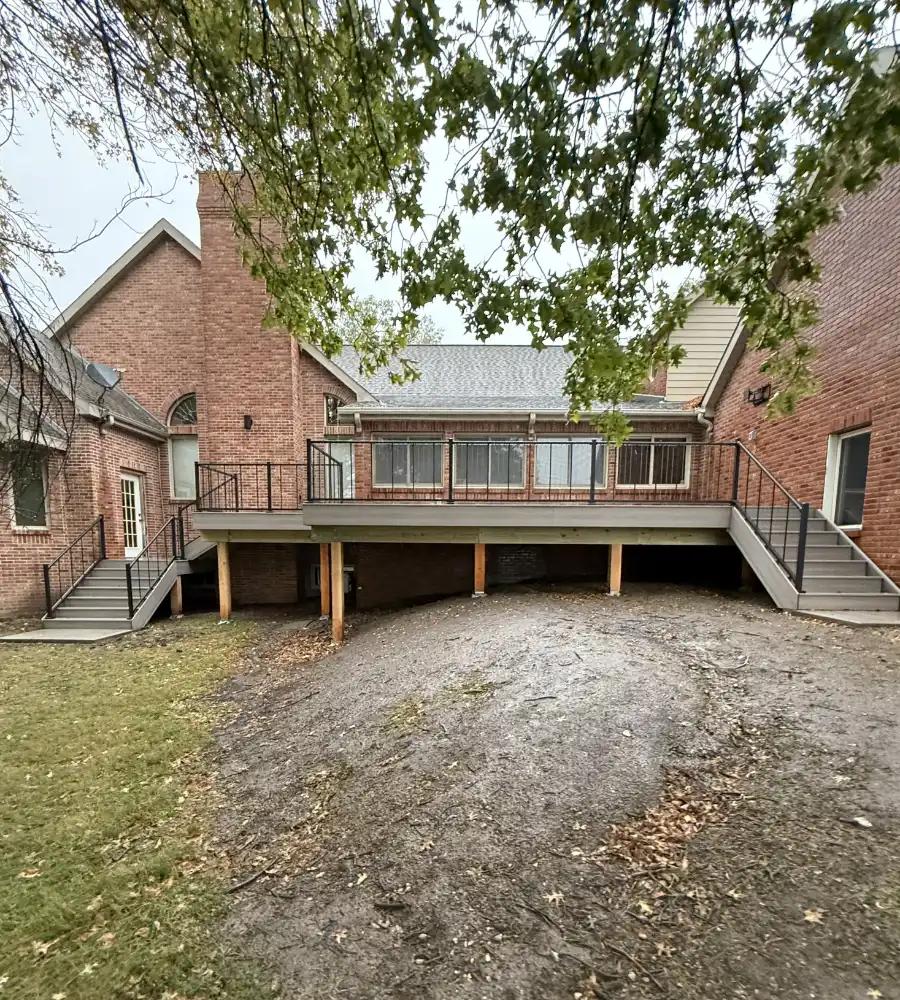

Check Out Their Deck Transformation
Learn what’s included in this project and see exactly how we built Henry and Laurie’s brand-new deck.
372 Sq. Ft. Large Composite Deck With Aluminum Cable Railing In Roca, NE
This project included:
- Design, planning, permitting
- 372 sq. ft. composite deck rebuild
- Fiberon GoodLife composite decking in Cabana
- 4 new stair sets, 15 steps in total
- Westbury C-10 aluminum vertical cable railing
- Grade 1 treated lumber framing
- Joist tape and ledger flashing for water protection

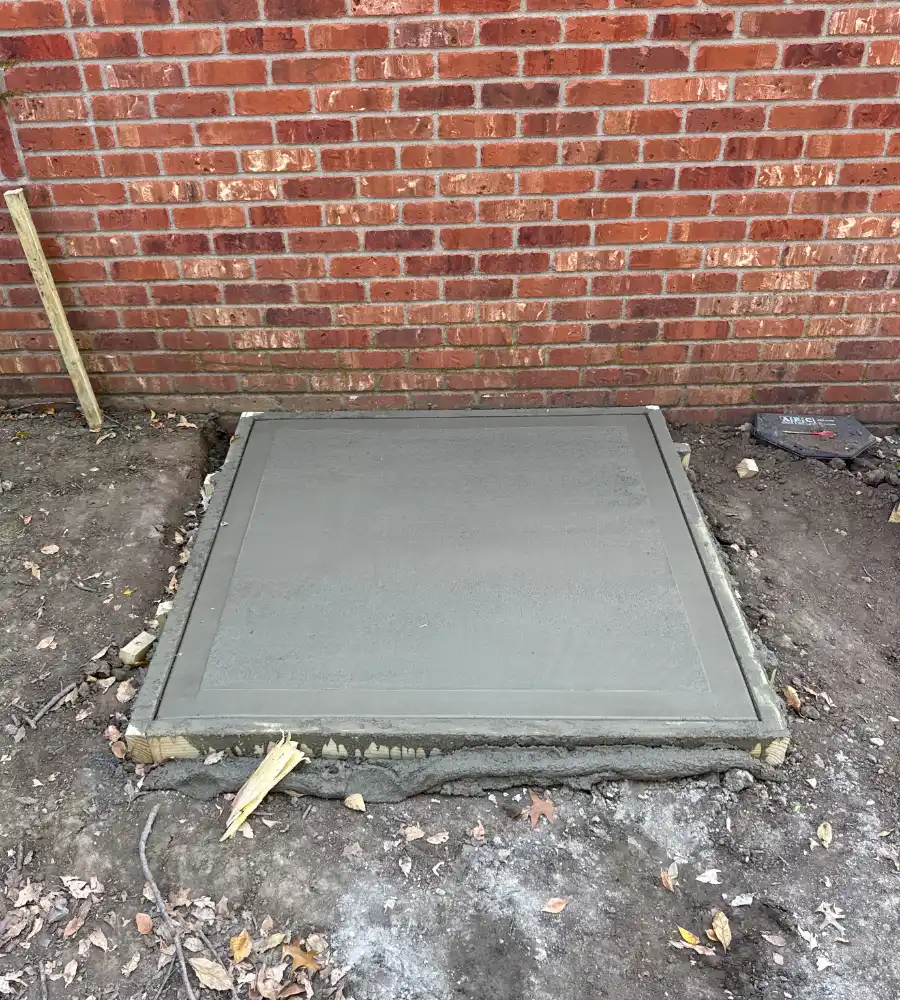

- 4x4 concrete pad at the base of the stairs
- Gutter downspout relocation
- 5-year workmanship guarantee

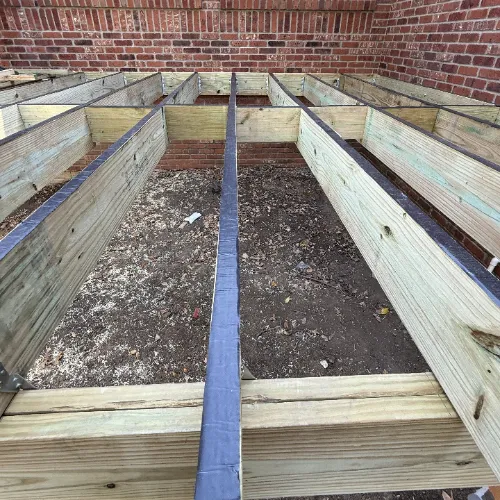

Grade 1 Treated Lumber Framing
Everything underneath the decking, the framing carrying the load, is grade 1 treated lumber. They’re protected against moisture with joist tape and flashing at every connection point.

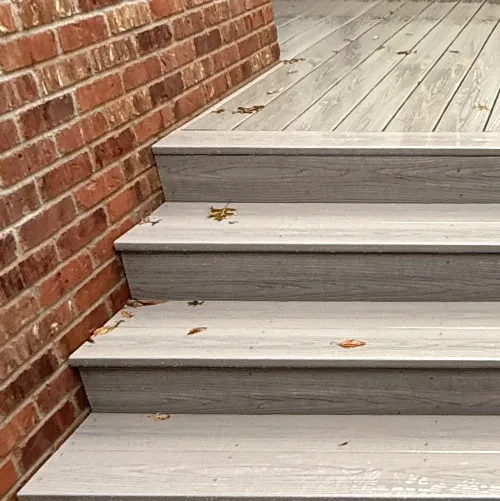

Fiberon GoodLife Decking in Cabana
Henry and Laurie wanted a deck surface that would hold its color and shrug off Nebraska weather without annual staining. Fiberon’s GoodLife line, picture-framed for a finished edge, backs that up with a 30-year warranty.

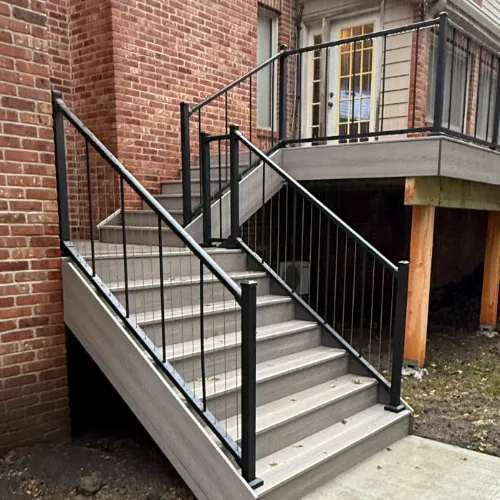

Westbury C-10 Aluminum Vertical Cable Railing, Black
The black cable railing gives the deck a clean, modern line without blocking the yard view. Built perfectly to Henry’s spec, it runs only along the outer stair edges, keeping the brick walls clear.
Materials And Finishes Used
This Deck Was $38,000
The main build itself took only 5 days. Add in the gutter work, the entire construction phase took 11 days.

Hi! I'm Luan, The Owner Of Deck Bros
A great deck is one you actually use for hosting friends, relaxing after work, or just enjoying your yard. But getting there depends on how it’s built.
At Deck Bros, we’re committed to a fair estimate up front, daily progress updates with photos, full visibility into your receipts and invoices, and a process that stays simple on your end.
From our signature 3-day builds to a larger outdoor spaces designed to impress, we’re proud to hold our work above industry standard.
800+
new decks built
300+
decks repaired
30+
years of carpentry experience
3-day
build time available
Trusted By Homeowners Across Omaha, NE
Hear directly from the families we’ve built decks for, in their own words.
